Nyakuza Suspended Footbridge

Duke Engineers for International Development x Engineers in Action

Objective

Every year during the rainy season, the Ingwavuma River in the Hosea Inkhundla of Eswatini’s Shiselweni region becomes impossible to cross, preventing community members from accessing critical resources. To address this pressing issue, Duke Engineers for International Development (DEID) worked with Engineers in Action (EIA) to design and construct a suspended footbridge crossing the river.

Quality Control

Outcome

Our team of students, EIA staff, local masons, and members of the Emanyonyaneni and Nsizatje communities successfully constructed the 128-meter Nyakuza Suspended Footbridge, which is now the longest pedestrian bridge in Eswatini! Spanning the Ingwavuma River, the bridge provides over 3,000 people with safe, year-round access to essential resources, including schools, healthcare facilities, and markets.

  • Issue: Sometimes the concrete mixtures were far too watery. We quickly had to figure out why and correct the problem to ensure our concrete was structurally sound and dried in time.

    Causes: Sand was delivered directly from the river, which caused the concrete’s moisture to vary based on how recently the sand was delivered. Some community members were also adding more than the allotted number of water buckets to the mixture.

    Solutions: We kept detailed records of sand deliveries and made note of how much water to use based on how fresh the sand was. We also worked with our site coordinator to give morning announcements in both English and SiSwati to share how many buckets to use that day and emphasize the importance of not adding extra water.

  • Issue: About halfway through the construction process, our Design and Construction Managers identified that we needed to change the widths of some of our walls, which conflicted with our established tolerancing.

    Solution: We worked closely with our Bridge Corps—a group of professional engineers mentoring us throughout the duration of the project—to understand the implications of the design changes and establish new tolerances.

  • Issue: A small group of students that didn’t include a QCM stayed back at our homestead to bend suspenders out of rebar. The group didn’t quality check their work, which resulted in 70 mis-bent pieces of rebar.

    Solution: This issue taught us that quality control is a group responsibility, and we had to ensure all of our teammates were conducing intermittent QC checks when they were working on tasks without a QCM present. Following this incident, we emphasized the importance of quality control in our morning meetings and made sure groups working off-site were informed of proper QC procedures before beginning their work.

Check out some of my favorite QC photos below!

Skills

  • Quality Control

  • AutoCAD

  • Technical Documentation

  • Global Development Engineering

  • Cross-Cultural Teamwork

  • Time & Resource Management

  • Adaptability

For this project, I served as one of our team’s two Quality Control Managers. As QCM, my responsibilities included:

  • Establishing optimal concrete mix ratios and recording daily material usage

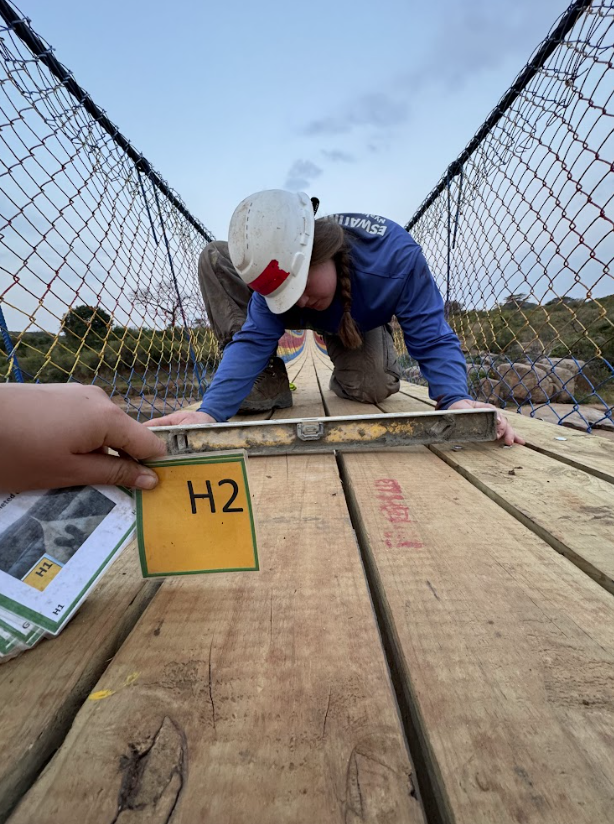

  • Ensuring accuracy of as-built dimensions within required tolerances and producing redlined engineering drawings

  • Maintaining extensive photographic documentation to support project evaluation

  • Overseeing the construction process to ensure proper sequencing and high-quality execution at each stage

The construction process wasn’t always straightforward, and Sienna (my co-QCM) and I had to quickly adapt to changing construction plans and resolve quality control issues. Here’s some of the challenges we faced and how we solved them:

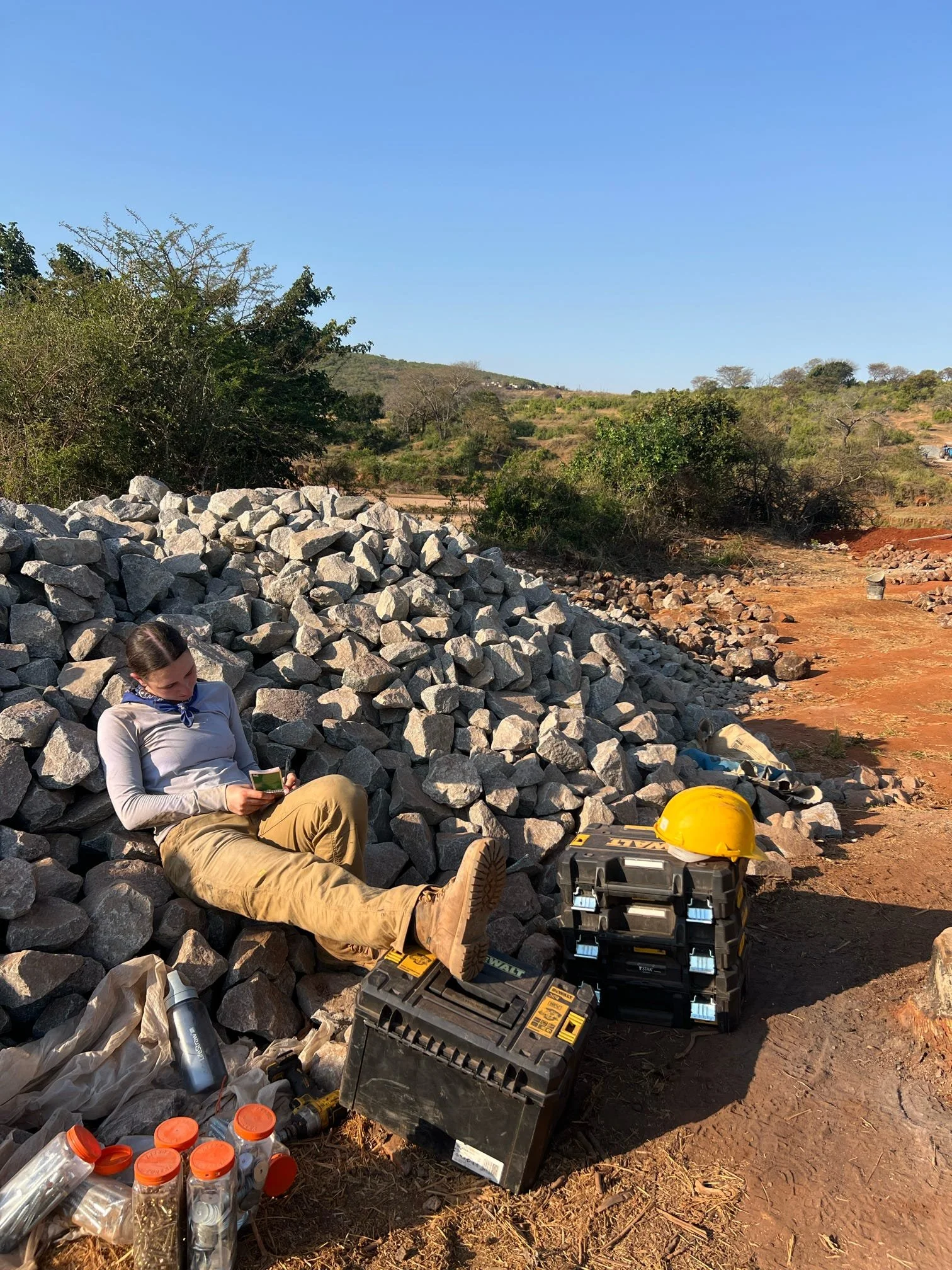

Recording the day’s concrete ratios and material usage (it’s comfier than it looks!)

On- and off-site highlights!

First day on site!

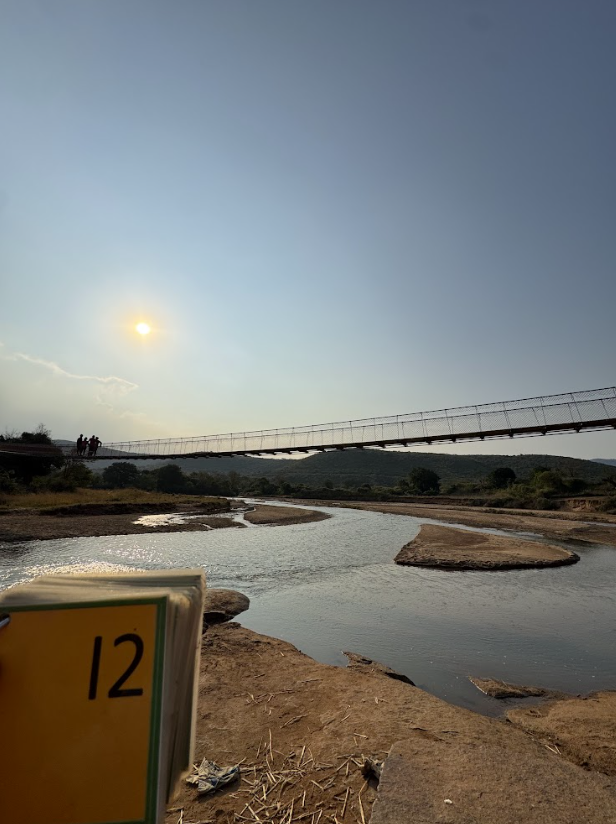

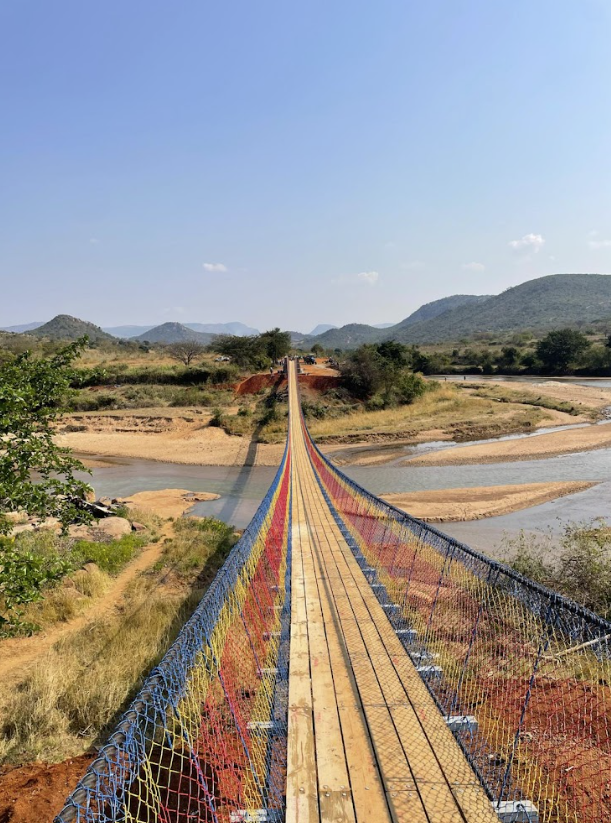

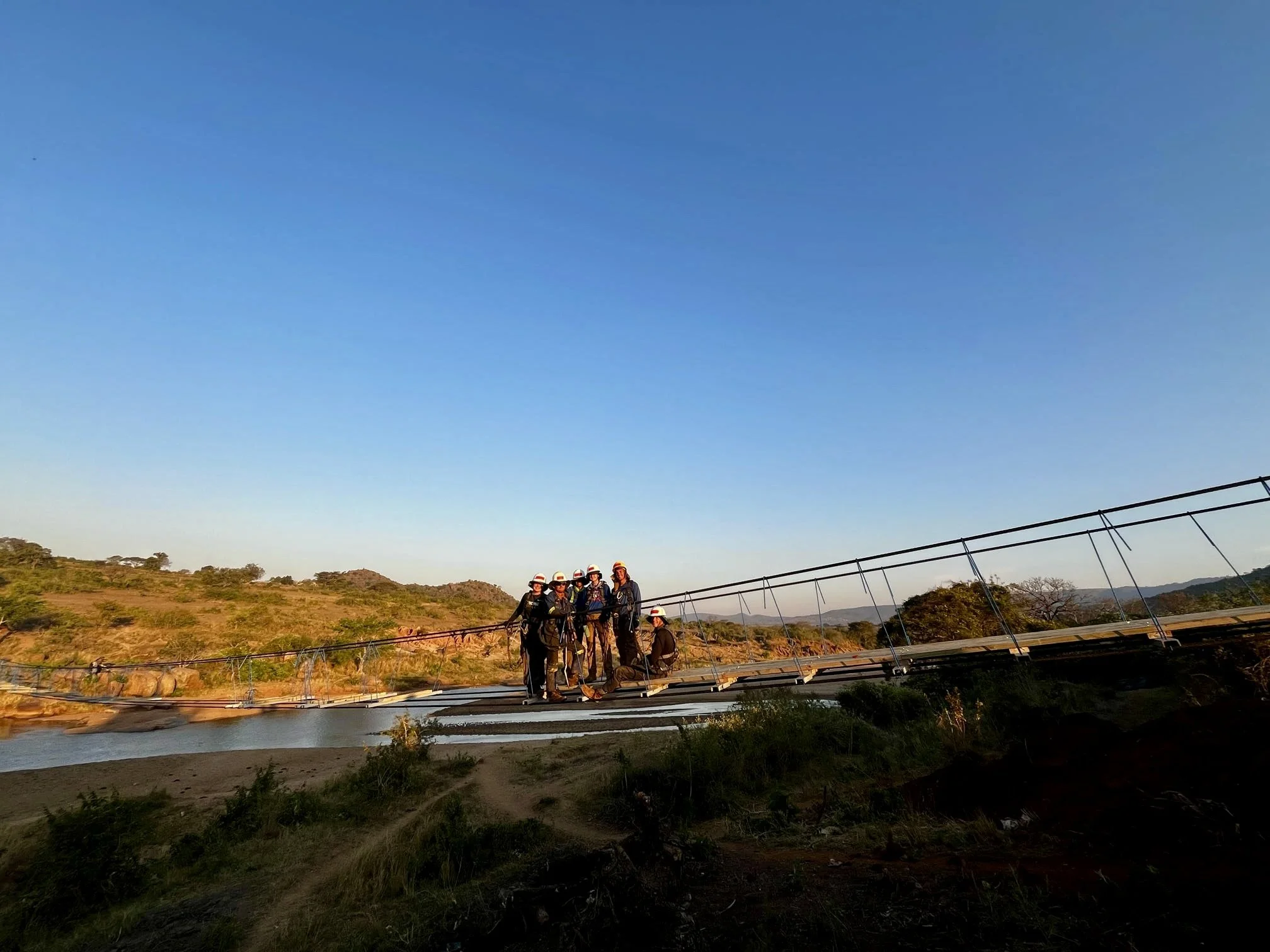

Decking the bridge and finally being able to cross the Ingwavuma River

Conclusion

Playing a soccer match against the local community team

Celebrating inauguration day with community members, local chiefs, and members of parliament

The construction of the Nyakuza Suspended Footbridge is without a doubt the most meaningful and rewarding project I’ve been a part of. In terms of technical and project management skills, I learned so much about technical documentation, quality control, and collaboration within a multidisciplinary team. More importantly, I saw firsthand how powerful engineering can be when it comes to improving safety, access, and quality of life. This experience solidified my passion for human-centered engineering, and I aspire to continue creating meaningful, lasting change with my future work.
